Skip to content

Wix: a six-month communication plan to go from “easy” to “professional”

The brief was an organization spokesperson’s semi-annual work plan, week by week. I chose Wix: a platform with over 200 million users that the market associates with “easy and generic”, even though its capabilities are already professional-grade. The plan closes that gap with 70 actions over 24 weeks, from internal communication to press, social media and social responsibility.

Role
Author. Diagnosis, strategy, audiences and messages, spokespeople, channels, a 70-action plan on a 24-week Gantt chart and indicators.
Year
2025–26
Stack
Integrated communicationPublic relationsInternal communicationMedia planGantt
Where
MA coursework, Strategic and Digital Advertising, Ariel University
Team
Individual

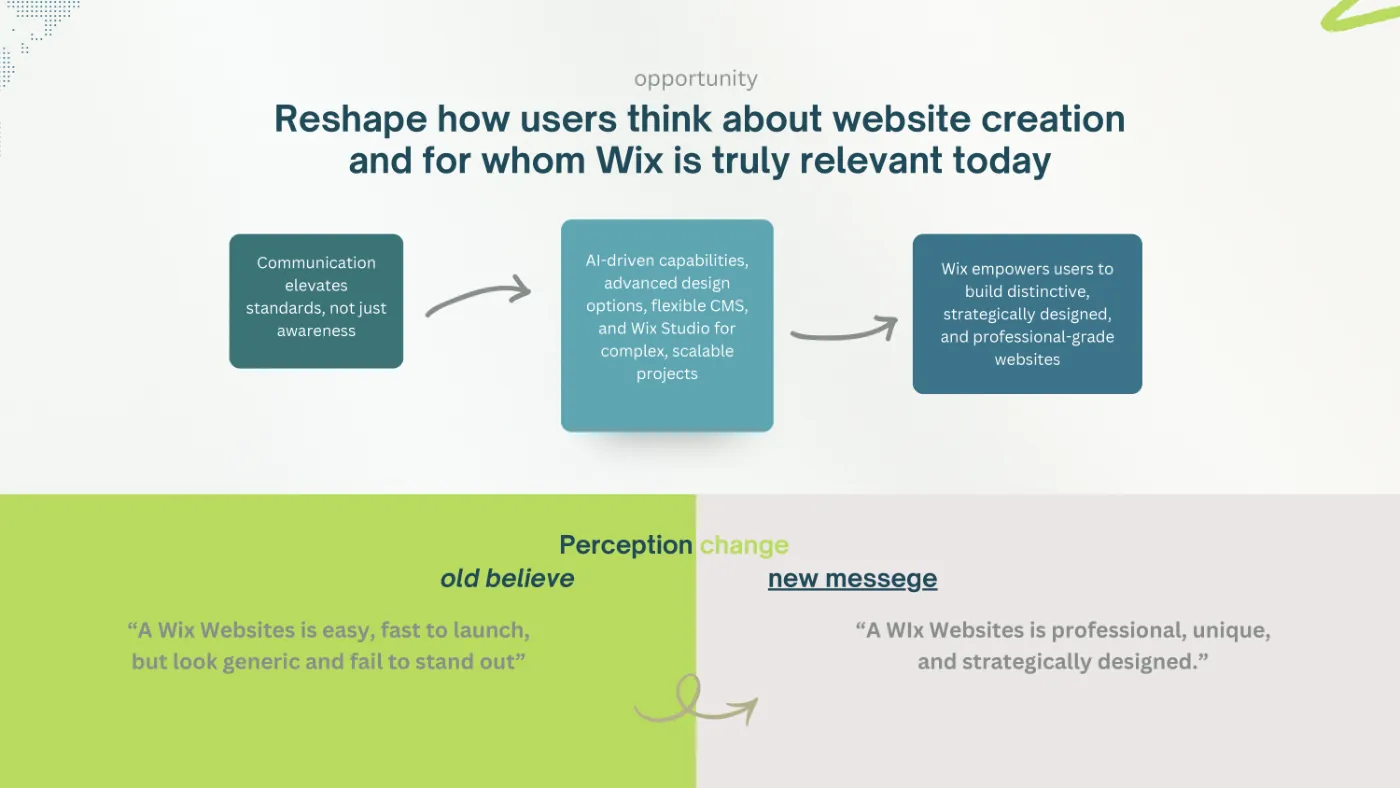

Slide Opportunity: shifting the perception from “a Wix website is easy but generic” to “professional, unique and strategically designed”
The perception shift that orders the whole plan: from “easy and generic” to “professional, unique and strategically designed”. Tap to enlarge.

The starting point: capability exceeds perception

Wix let more than 200 million people and businesses publish fast. That accessibility was a success and, at the same time, left an image: look-alike sites, drag and drop, templates. Meanwhile, the platform added AI capabilities, advanced design options, a flexible CMS and Wix Studio for complex projects. The gap is not in the product: it is in how people think about it. The strategy is called “Beyond Democratization”: moving the market’s perception toward a professional standard.

Cover of the presentation: Wix.com, with the plan’s three blocks
The cover: background and opportunity, audiences and messages, timeline and strategy.

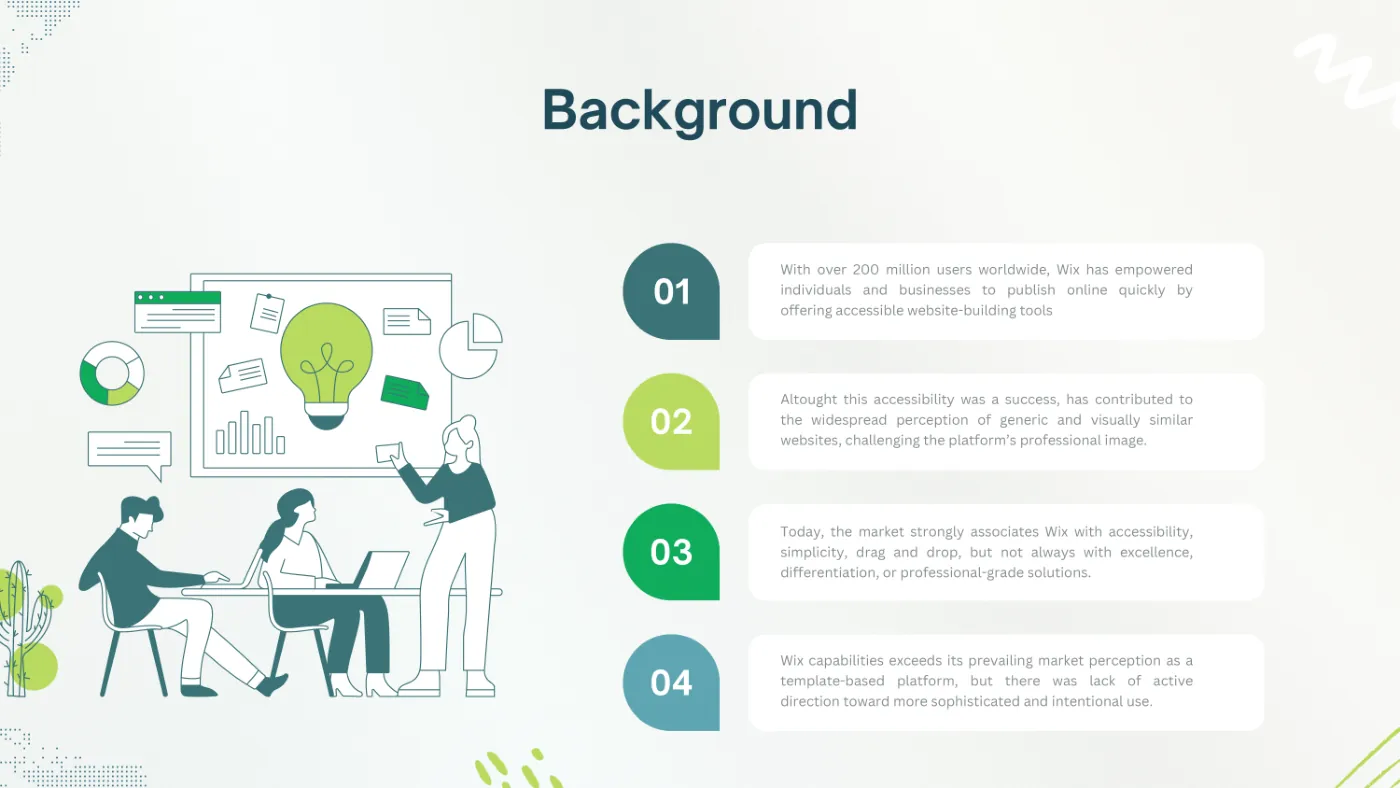

Slide Background with four points on Wix’s situation
Background: 200 million users, a template image and capabilities that exceed it.

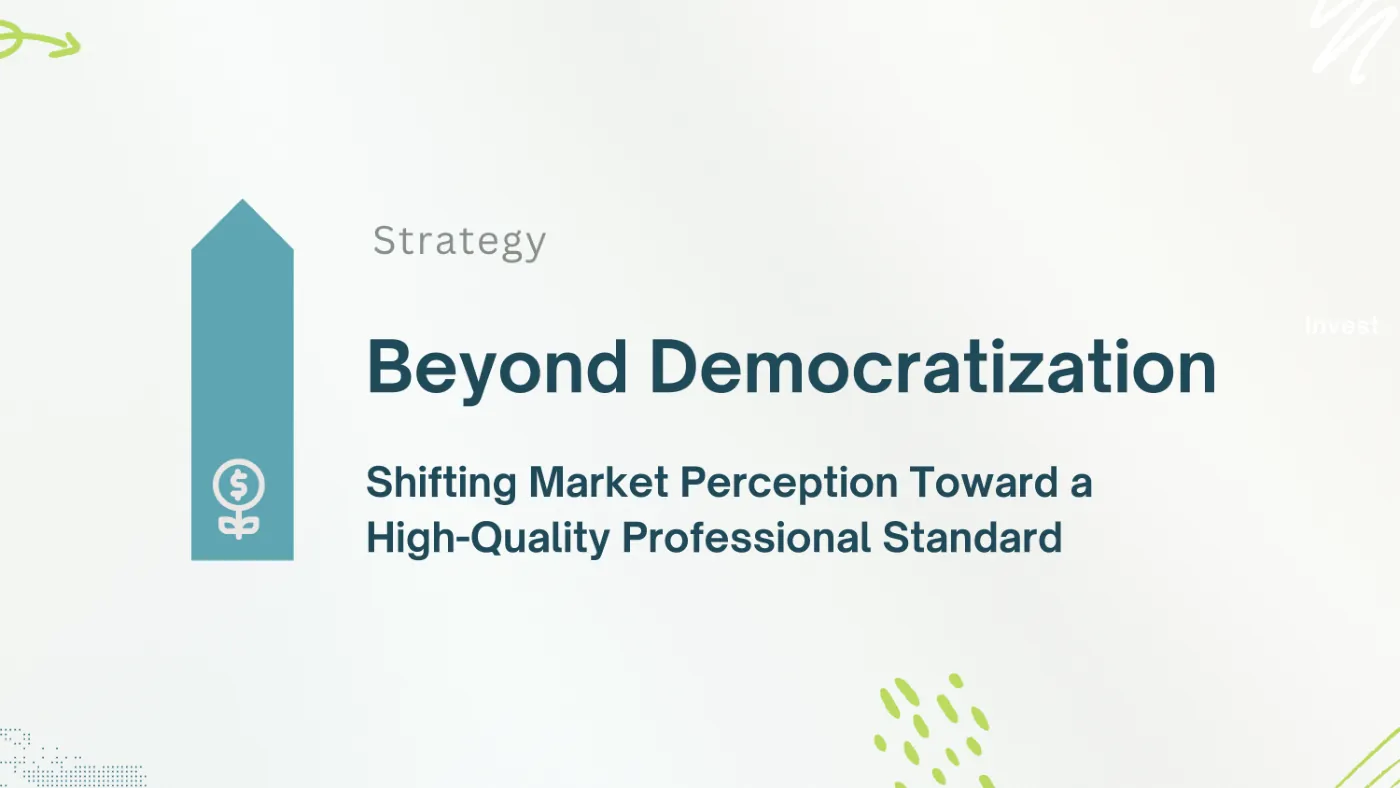

Slide Strategy: Beyond Democratization
The strategy: “Beyond Democratization”.
1 / 3

Swipe sideways or use the arrows. Tap a screenshot to enlarge it.

Three audiences, three messages

Existing medium-sized businesses whose website no longer reflects their growth: “upgrade your site into a professional, competitive one with advanced tools”. New entrepreneurs who set their standard from day one: “launch your first professional website, fully equipped from the start”. And corporate organizations that need to migrate without losing quality: “migrate and modernize your digital presence with integrated solutions”.

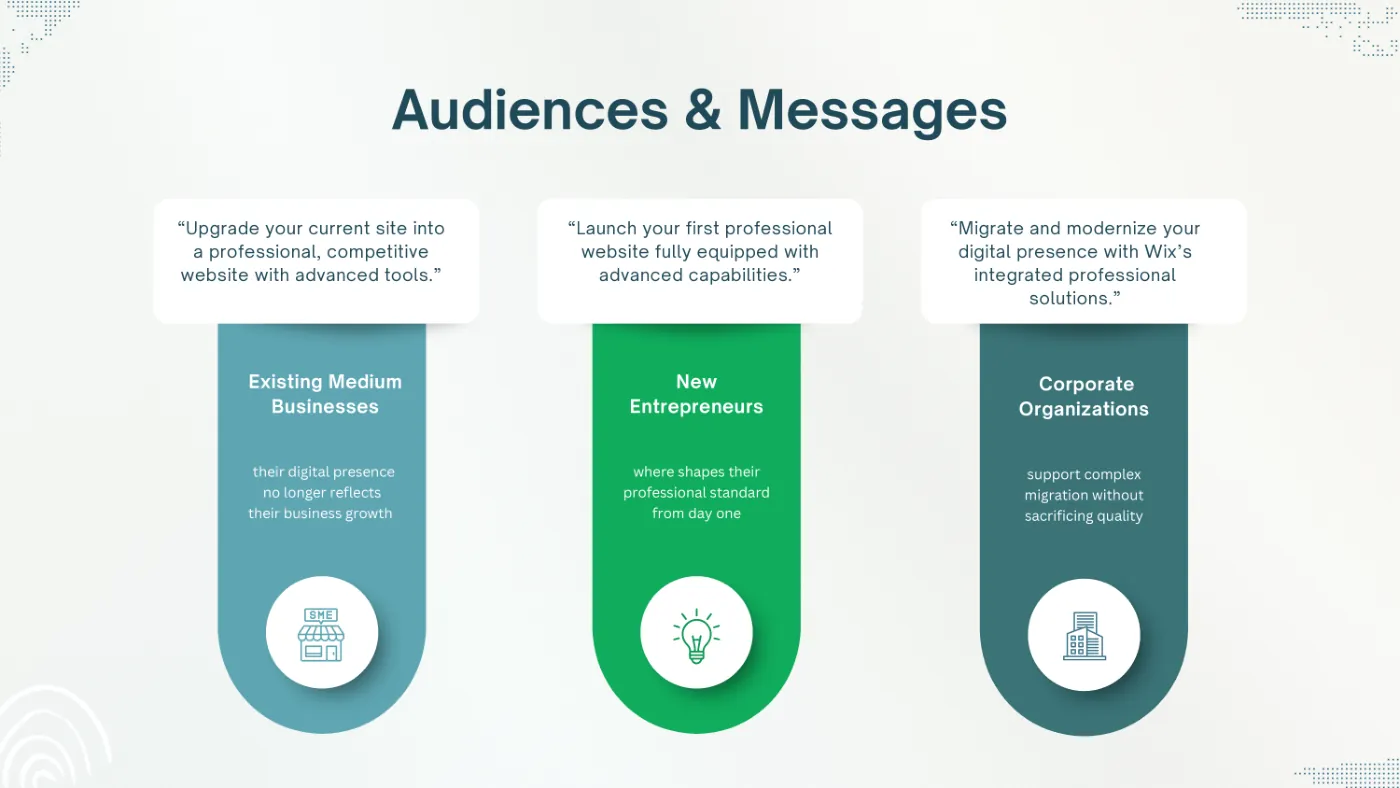

Slide Audiences and messages: existing medium-sized businesses, new entrepreneurs and corporate organizations
Three audiences, one message for each. Tap to enlarge.

Mass communication for a standard, not for a product

Mass media is not used to explain features but to set a bar: what a professional website means today, what digital maturity looks like, what every user should expect from their own site and how design decisions shape the outcome. Two examples from the plan: a global summit where the brand announces its pivot toward the enterprise market and an exclusive profile of its leadership in a technology magazine.

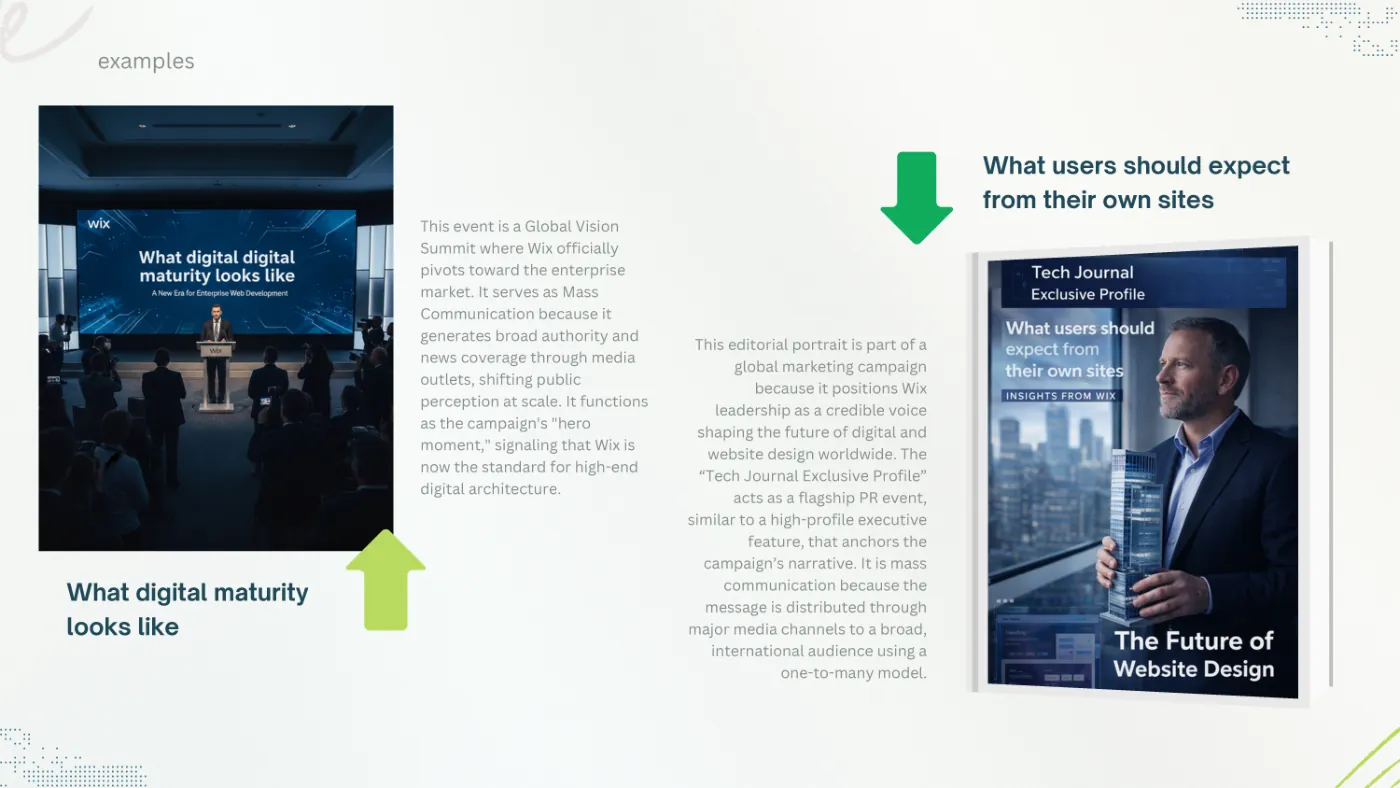

Examples: a global vision summit and an exclusive profile in a technology magazine
Examples: the global summit and the profile in a technology magazine.

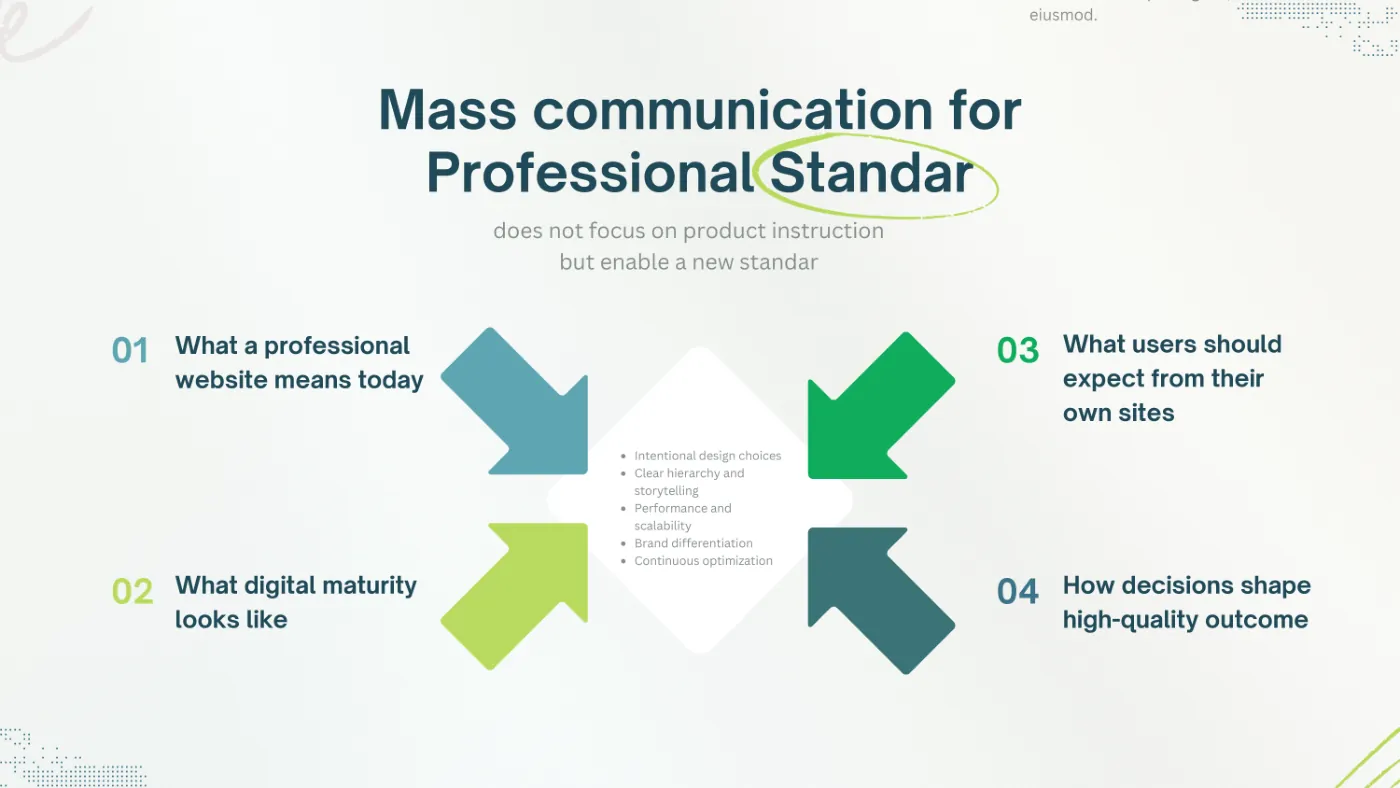

Slide Mass communication for a professional standard with four themes
Four themes for mass media.
1 / 2

Swipe sideways or use the arrows. Tap a screenshot to enlarge it.

Two voices, and public relations that are earned

Credibility comes from a dual authority: the person leading the company represents the vision and the long term; UX leaders bring external validation, because professional standards emerge from real usage and design decisions. The channels follow from there: press releases, conferences, university panels, customer testimonials, industry forums and visits with demos. And one rule for public relations: legitimacy is earned, not declared. The stories that go to press are about real users who redesigned, grew or migrated.

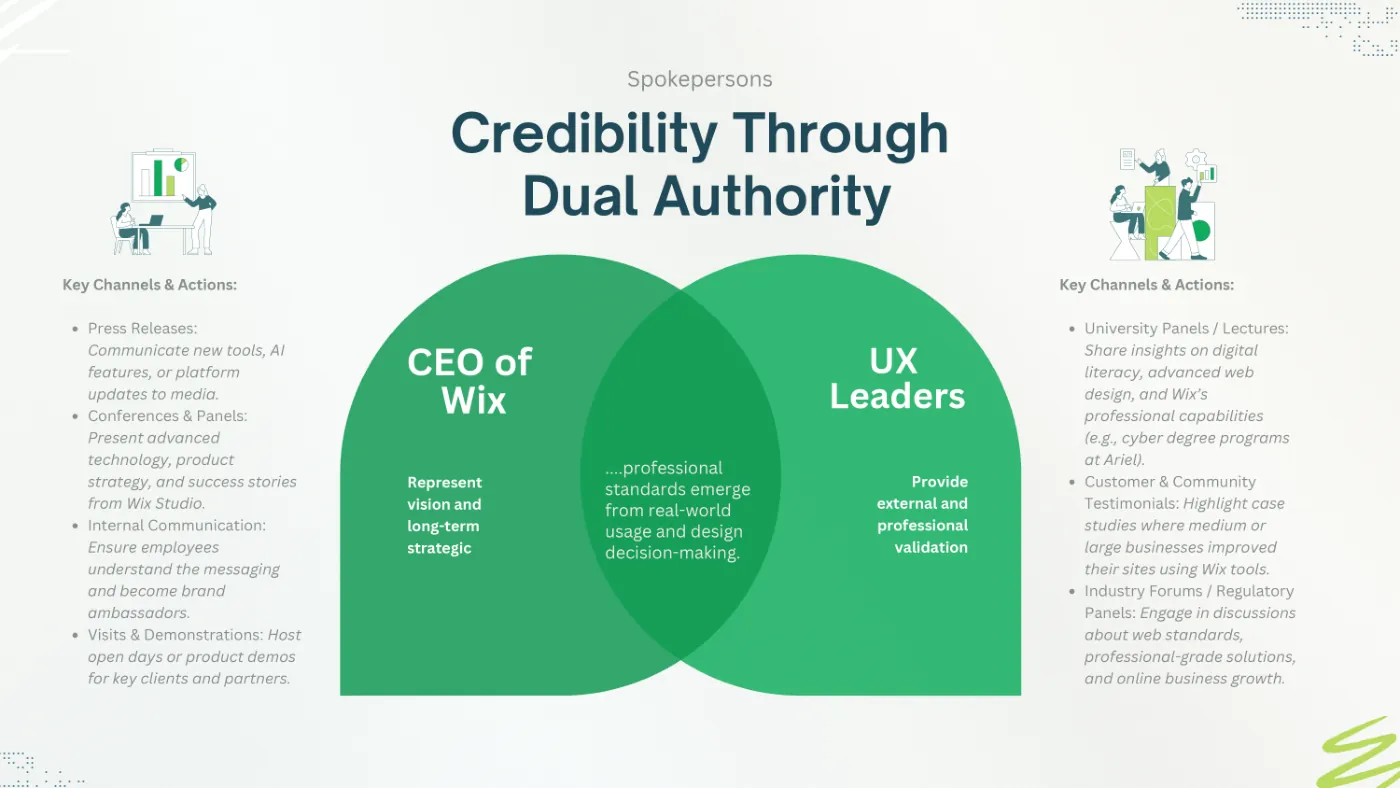

Slide Credibility through dual authority: Wix’s leadership and UX leaders, with channels and actions
Two voices: the leadership (vision) and UX leaders (external validation).

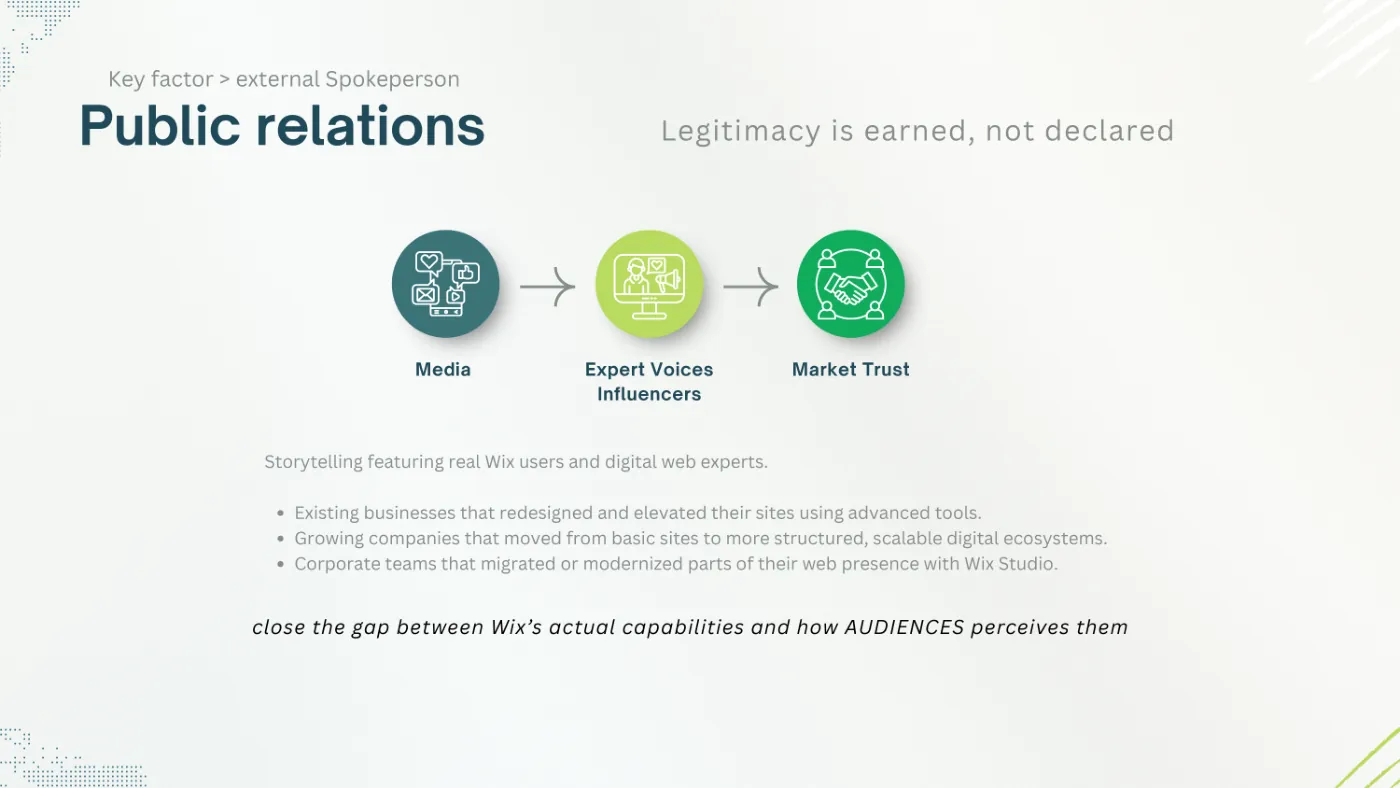

Slide Public relations: media, expert voices and market trust
Public relations: media, expert voices, market trust.
1 / 2

Swipe sideways or use the arrows. Tap a screenshot to enlarge it.

Digital and social: where the shift becomes practice

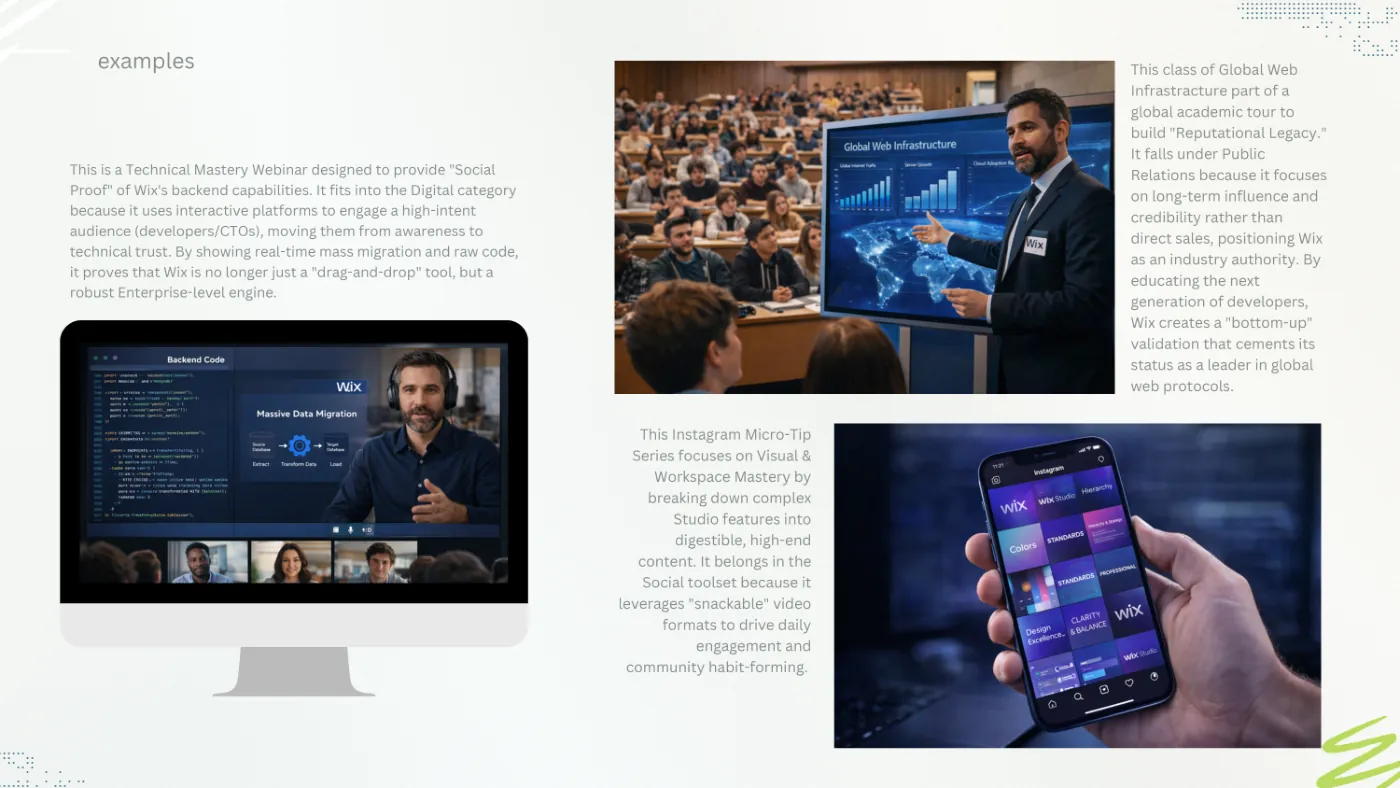

Each network has a job. Instagram shows the before and after of real sites and the decisions behind them. TikTok normalizes professional decisions with short video: real workflows and “why this works”. X is the real-time conversation about standards, UX and AI. LinkedIn connects the platform with business growth: agency perspectives, UX leadership, migration stories. YouTube explores at length what digital maturity looks like in practice. Examples from the plan: a technical webinar on large-scale migration, a series of micro-tips on Instagram and a class on web infrastructure during an academic tour.

Examples: technical webinar, micro-tips on Instagram and a class on an academic tour
Examples: technical webinar, micro-tips and an academic class.

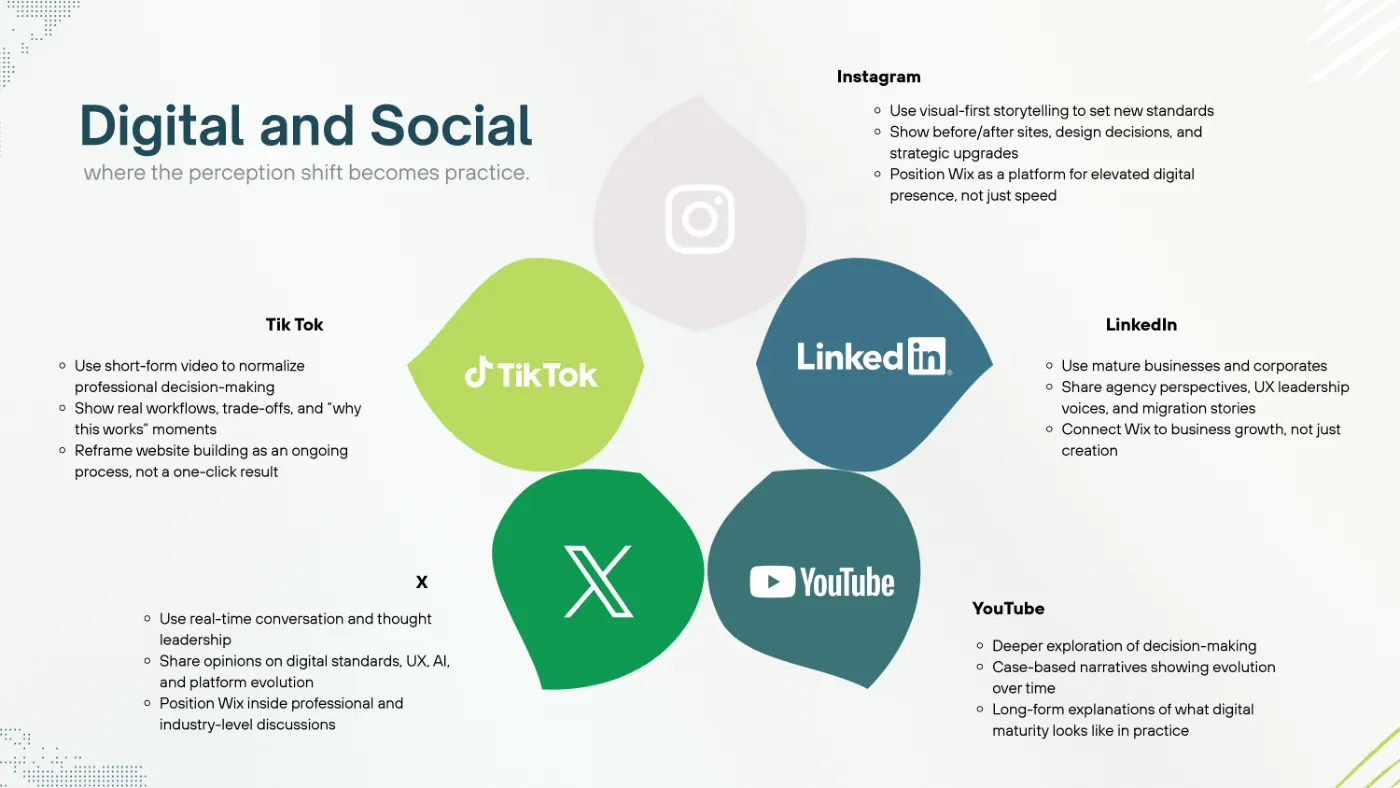

Slide Digital and social with the role of Instagram, TikTok, X, LinkedIn and YouTube
One role per network.
1 / 2

Swipe sideways or use the arrows. Tap a screenshot to enlarge it.

The transformation begins within

Professional maturity cannot be projected if the sales and development teams still think in terms of “simple template”. That is why the plan starts with internal communication: early access to the new tools, demo sessions, internal messages about launches and best practices, role briefings for marketing, sales and UX, and an ambassador program with internal contests. An internal launch event aligns everyone before any public announcement.

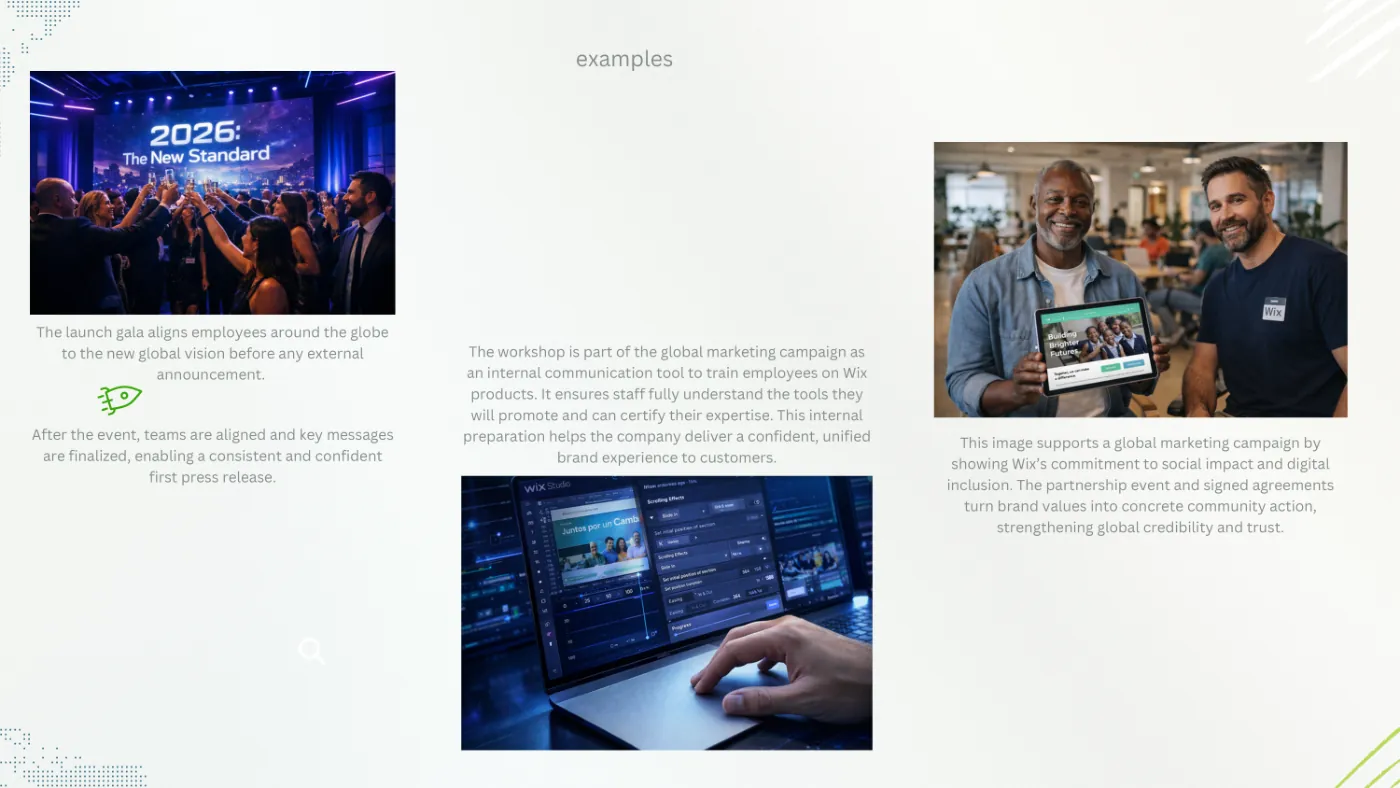

Examples: the internal launch event, a product workshop and the signing of an agreement with a social organization
Examples: the internal event, the workshop and an agreement with a social organization.

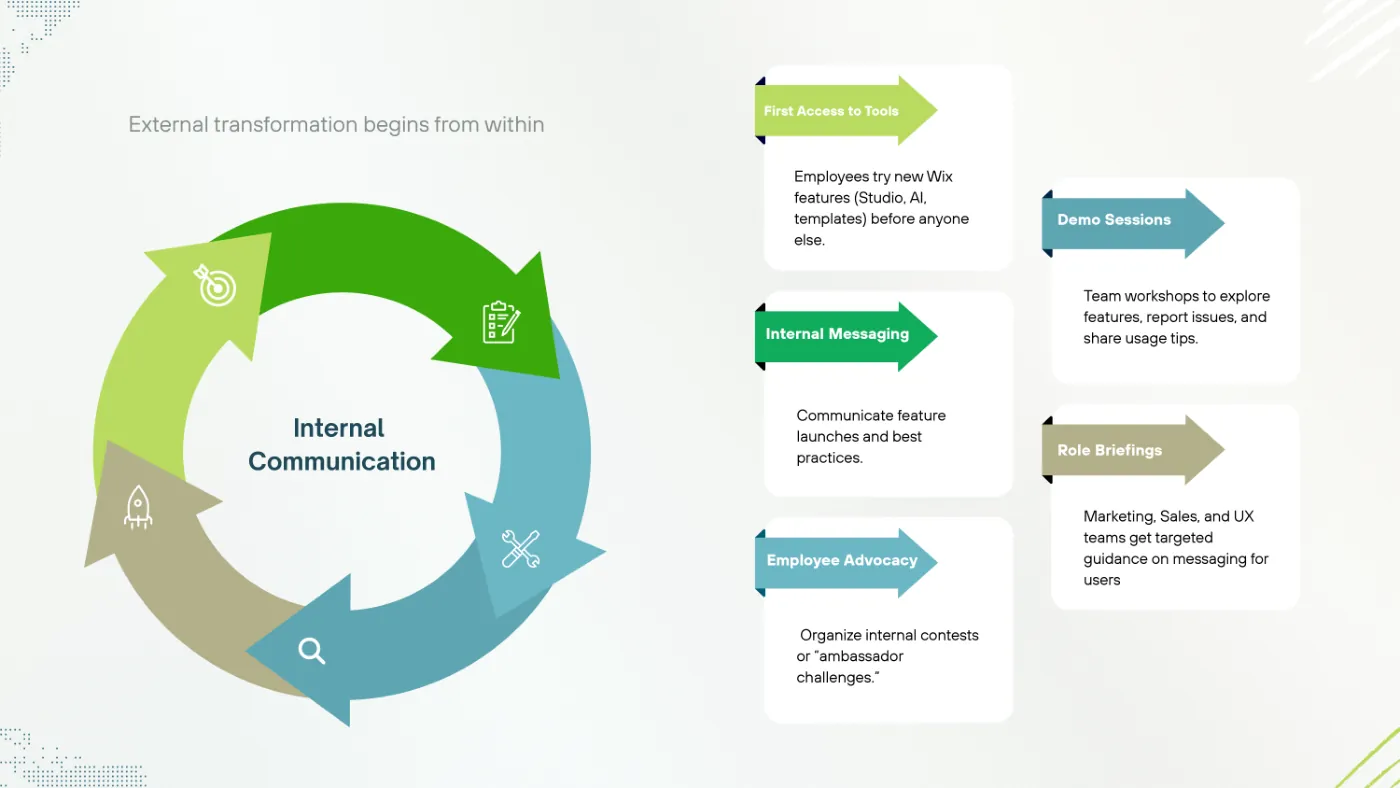

Slide Internal communication: early access, demo sessions, internal messaging, role briefings and ambassadors
Internal communication: five moves.
1 / 2

Swipe sideways or use the arrows. Tap a screenshot to enlarge it.

Responsibility to the community

Wix as a responsible actor in the digital ecosystem, not just a technology provider: reduce the access gap to professional tools, raise digital literacy and strategic thinking in web design, and measure the impact in educational, social and reputational terms. In the plan: a certification program for NGOs, school workshops, a grant announcement and an impact report at the end.

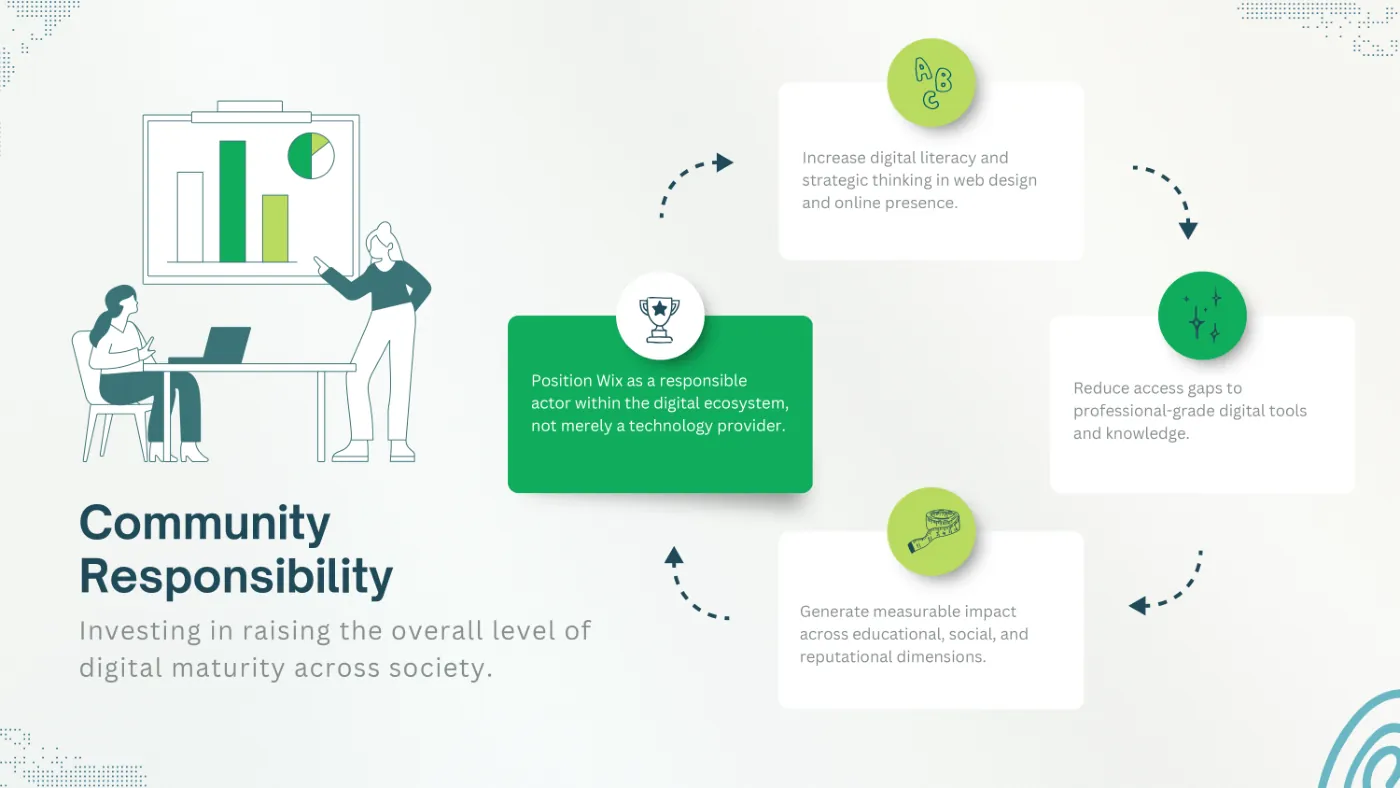

Slide Community responsibility: investing in raising society’s digital maturity
Responsibility to the community. Tap to enlarge.

The plan: 70 actions over 24 weeks

Everything above becomes a 24-week Gantt chart with 70 numbered actions, each with its category, its strategic goal and the strategy slide that justifies it. Four phases: internal mastery and cultural shift; professional authority and academic launch; social saturation and enterprise leadership; reputation consolidation and social impact. The control actions (fortnightly syncs, a perception audit mid-campaign and another at the end, weekly AI sentiment analysis) run in parallel.

CategoryActionsExamples
Internal communication13Leadership video, early access to Studio, ambassador contest, final staff survey
Public relations11Technical briefing with editors, university panel, roundtable with the leadership, signing with a UX association
Mass media8“Closing the Gap” press release, op-ed, TV segment, “The 2026 Shift” documentary
Digital6Studio case-studies landing page, digital maturity quiz, whitepaper, migration webinar
X · TikTok · LinkedIn · Instagram · YouTube22Daily threads, “The Craft” series, articles with agencies, before and after, infrastructure docuseries
Out of home1Billboards in business districts
Social responsibility4Certification for NGOs, school workshops, grants, impact report
Control5Fortnightly syncs, perception audits, sentiment analysis

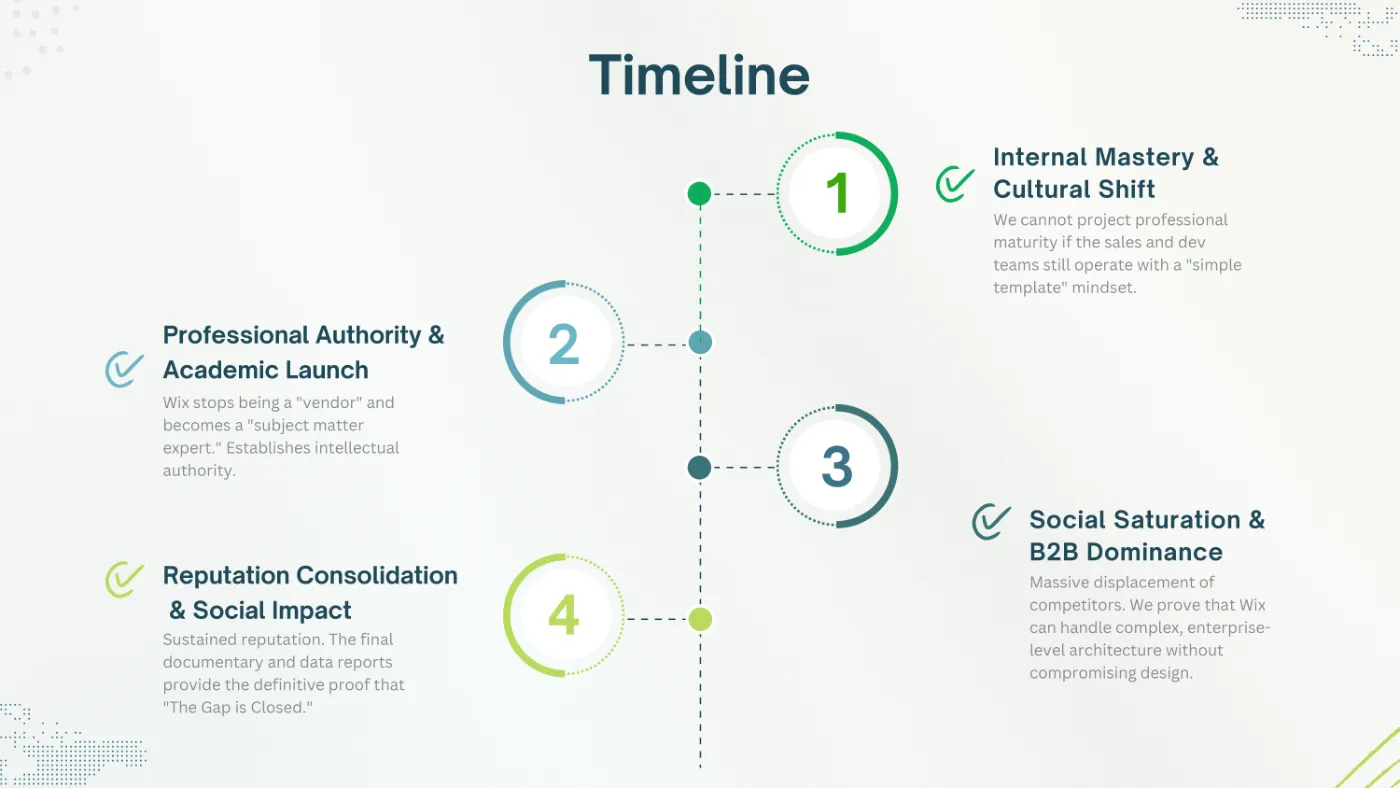

Slide Timeline with the plan’s four phases
The four phases. Tap to enlarge.

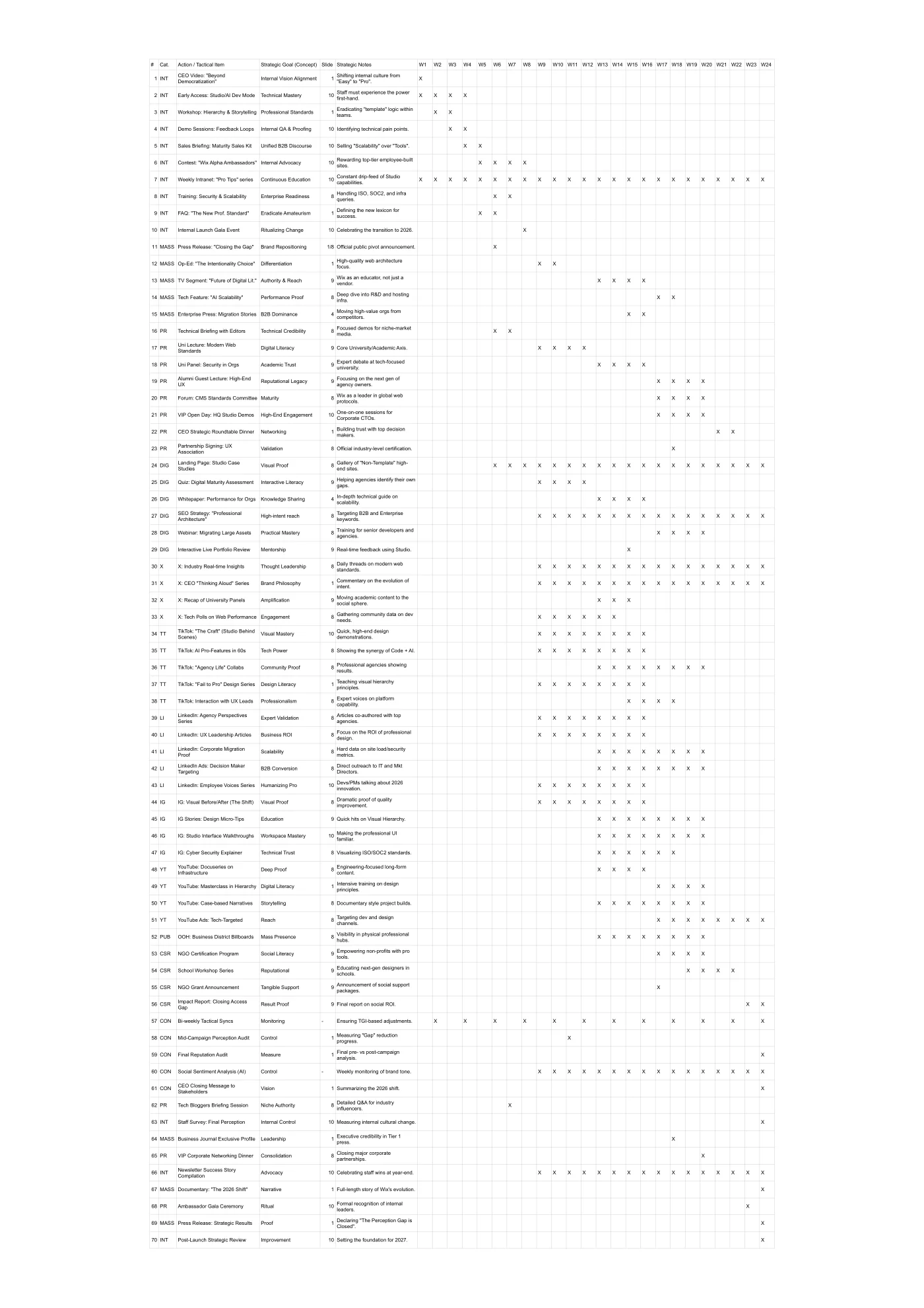

Gantt chart with the 70 actions over 24 weeks, by category, with strategic goal and reference slide
The full Gantt chart: 70 actions, 24 weeks. It scrolls.

How to know whether it worked

Four indicators: internal alignment (that staff live the professional identity, measured with a survey at the end); capturing the enterprise and agency market (it has to show in results and in clients arriving from competitors); the impact of social responsibility (beyond the social, investor attraction on ESG criteria); and the label change, from “amateur” to “professional architecture”, measured in the coverage and the dialogue generated on X, LinkedIn and mass media.

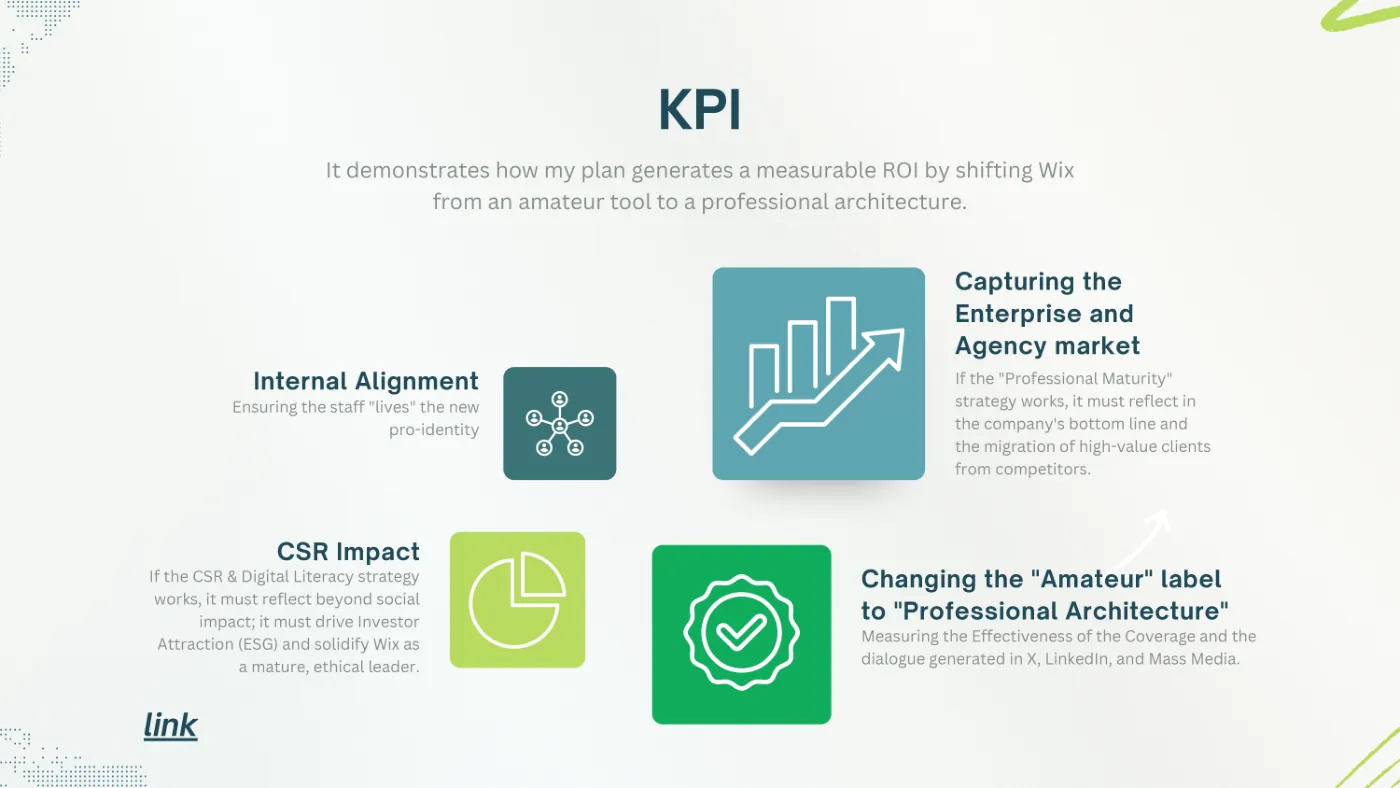

Slide KPI with four indicators: internal alignment, enterprise and agency market, social impact and label change
The four indicators. Tap to enlarge.

What I took away

That a communication plan is a single idea repeated through 70 different doors, and that order matters: first inside, then authority, then volume, and proof at the end. The Gantt chart is the part of the work I use most today: one action per row, one week per column, and a strategic reason for every cross.
